You want to renovate everything. The kitchen cabinets are stuck in 1997, the primary bathroom feels cramped, the basement is an unfinished cavern of lost potential, and the living room carpet has survived three dogs and two toddlers. The impulse is to rip it all out and start fresh. But unless your budget is limitless and you have somewhere else to live for six months, the smarter move is to renovate room by room in a deliberate sequence.

The order in which you remodel rooms is not a cosmetic decision. It directly affects how much you spend, how much disruption your family absorbs, and how polished the final result looks. Dust migrates. Plumbing lines connect. Flooring transitions matter. Get the sequence wrong, and you end up redoing work you already paid for. Get it right, and each phase builds on the last, saving money and delivering better results at every stage.

This guide provides a data-driven framework for Omaha homeowners to decide which rooms to tackle first, how to sequence multi-room projects, and how to live through the process without losing your mind.

What You'll Learn:

Why Remodel Order Matters

Most homeowners choose which room to remodel based on which one bothers them the most. That is an emotional decision, not a strategic one. Here is why the order of operations matters from a construction standpoint:

Dust and Debris Flow Downhill

Demolition on an upper floor sends dust through HVAC ducts, down stairwells, and into every room below. If you renovate a main-floor kitchen first and then gut a second-floor bathroom, drywall dust will settle on your brand-new countertops. The rule is simple: work from the top of the house down. Second floor first, main floor second, basement last.

Plumbing and Electrical Rough-In Should Be Consolidated

Every time you bring a plumber or electrician to the job site, you pay a mobilization cost. If your kitchen and two bathrooms all need new supply lines or upgraded circuits, it is far cheaper to rough in all three at once than to bring the same subcontractor back three separate times over the course of a year. Consolidating rough-in work can reduce mobilization and coordination costs, often resulting in measurable savings on plumbing and electrical alone.

Flooring Goes In Last

New hardwood or luxury vinyl plank should be the final installation in any room. Foot traffic from contractors, dropped tools, paint drips, and heavy appliance installs will damage flooring that goes down too early. If you are running continuous flooring through multiple rooms, all the wall work, painting, and cabinet installation in those rooms needs to be finished before the flooring crew arrives.

HVAC Modifications Affect Adjacent Rooms

Removing a wall, adding a room, or converting a basement changes the heating and cooling load on your system. If your HVAC needs ductwork modifications, those changes can affect airflow in rooms you have already finished. Plan HVAC work early in the project so the system is balanced before you install finishes.

Remodeling ROI: What the Data Actually Shows

The most widely cited source for renovation return on investment is the Remodeling 2025 Cost vs. Value Report published by Remodeling Magazine (Zonda Media). The report tracks ROI by project type across nine U.S. regions, including the Midwest. It does not publish room-level ROI, so the room-based estimates below combine published CVV project data with regional contractor experience and Midwest resale trends.

Midwest remodeling ROI by project type bar chart showing Entry Door Replacement at 90-100%+, Siding Replacement at 70-85%, Minor Kitchen Remodel at 75-85%, Vinyl Window Replacement at 65-75%, Bathroom Remodel Midrange at 65-75%, and Basement Finish Midrange at 50-65%. Source: Remodeling Magazine Cost vs. Value Report, Midwest region.

Midwest remodeling ROI by project type. Source: Remodeling 2025 Cost vs. Value Report (Zonda Media). Percentages reflect regional averages and vary by scope and market conditions.

Published Cost vs. Value Categories

These project types are tracked in the CVV report. National averages are cited where available; Midwest region recoup typically trends lower and varies by metro area:

1. Minor Kitchen Remodel

Among the Highest-Return Interior Projects

A minor kitchen remodel — cabinet refacing or mid-grade replacement, updated countertops, new appliances, lighting, and flooring — is one of the highest-ranking interior projects in the CVV report nationally. The 2025 national average shows 112.9% cost recouped; Midwest recoup values typically trend lower than the national average and vary by metro area. Typical Omaha cost: $25K-$55K depending on scope.

CVV project type: Minor Kitchen Remodel (ranked #5 nationally, 112.9% national avg.). Midwest region results vary.

2. Bathroom Remodel (Midrange)

60-75% Cost Recouped (Varies by Region)

A midrange bathroom renovation — new vanity, fixtures, tile, and tub or shower replacement — performs strongly due to buyer expectations around condition and function. National and regional recoup typically ranges between 60-75%, depending on scope and market. Primary bathrooms trend toward the higher end. Typical Omaha cost: $10K-$30K.

CVV project type: Midrange Bathroom Remodel, Universal Design Bathroom

3. Steel Entry Door Replacement

Highest Per-Dollar Return Nationally

A steel entry door replacement ranks #2 nationally in the 2025 CVV report with a national average recoup of 216.4%. Midwest recoup varies by metro area. As a low-cost project (typically $2,000-$3,000 installed), it delivers outsized value per dollar spent. Note: this is a single-item exterior project, not a full foyer remodel.

CVV project type: Steel Door Replacement (ranked #2 nationally, 216.4% national avg.). Midwest region results vary.

4. Basement Finish (Midrange)

Varies by Market

Basement remodels are recently tracked in the CVV report and show "most consistent" results nationwide according to Zonda. In Omaha, where basements are standard, a finished lower level ($30K-$60K) adds a family room, guest suite, or home office. Cost recouped varies by quality and whether a bathroom is included.

CVV project type: Midrange Basement Remodel (recently tracked in CVV)

Market Observations (Not Directly Published in CVV)

The CVV report does not track these as standalone project categories. These estimates are based on Midwest resale trends and regional contractor experience:

5. Entry / Foyer Renovation

Est. 50-70% Cost Recouped

New flooring, a coat closet upgrade, better lighting, and fresh paint in the entryway cost relatively little ($3K-$8K) but immediately signal that the home is well-maintained. This is among the highest ROI-per-dollar investments based on contractor and realtor observations.

Market estimate — not a published CVV category

6. Living Room

Varies by Scope

Living room renovations range from a $2K paint-and-flooring refresh to a $25K open-concept conversion. Cosmetic updates (paint, flooring, lighting) can recover 60-70%. Structural changes like wall removal often recover less than 50% due to higher cost, though they transform daily livability.

Market estimate — not a published CVV category

7. Bedrooms

Est. under 50% ROI

Bedroom renovations rarely recover more than 50% at resale because buyers expect bedrooms to be functional as-is. However, a new closet system, fresh paint, and updated lighting ($2K-$8K per room) make an outsized difference in daily comfort. Prioritize bedrooms for livability, not resale value.

Market estimate — not a published CVV category

Source: Remodeling 2025 Cost vs. Value Report (Zonda Media). National percentages are cited where noted; Midwest region results vary by metro area. Room-level estimates for Entry/Foyer, Living Room, and Bedrooms are derived from regional contractor experience and Midwest resale behavior, not directly published CVV data. ROI percentages reflect average cost-to-value recoup at time of resale and do not represent profit. Actual results vary by property condition, design quality, and local market timing. For detailed metro-specific recoup data, homeowners can review the full report at zondahome.com.

The Strategic Remodel Sequence

Based on construction logic, ROI data, and the practical realities of living in a house during renovation, here is the recommended five-phase sequence for a multi-room interior remodel:

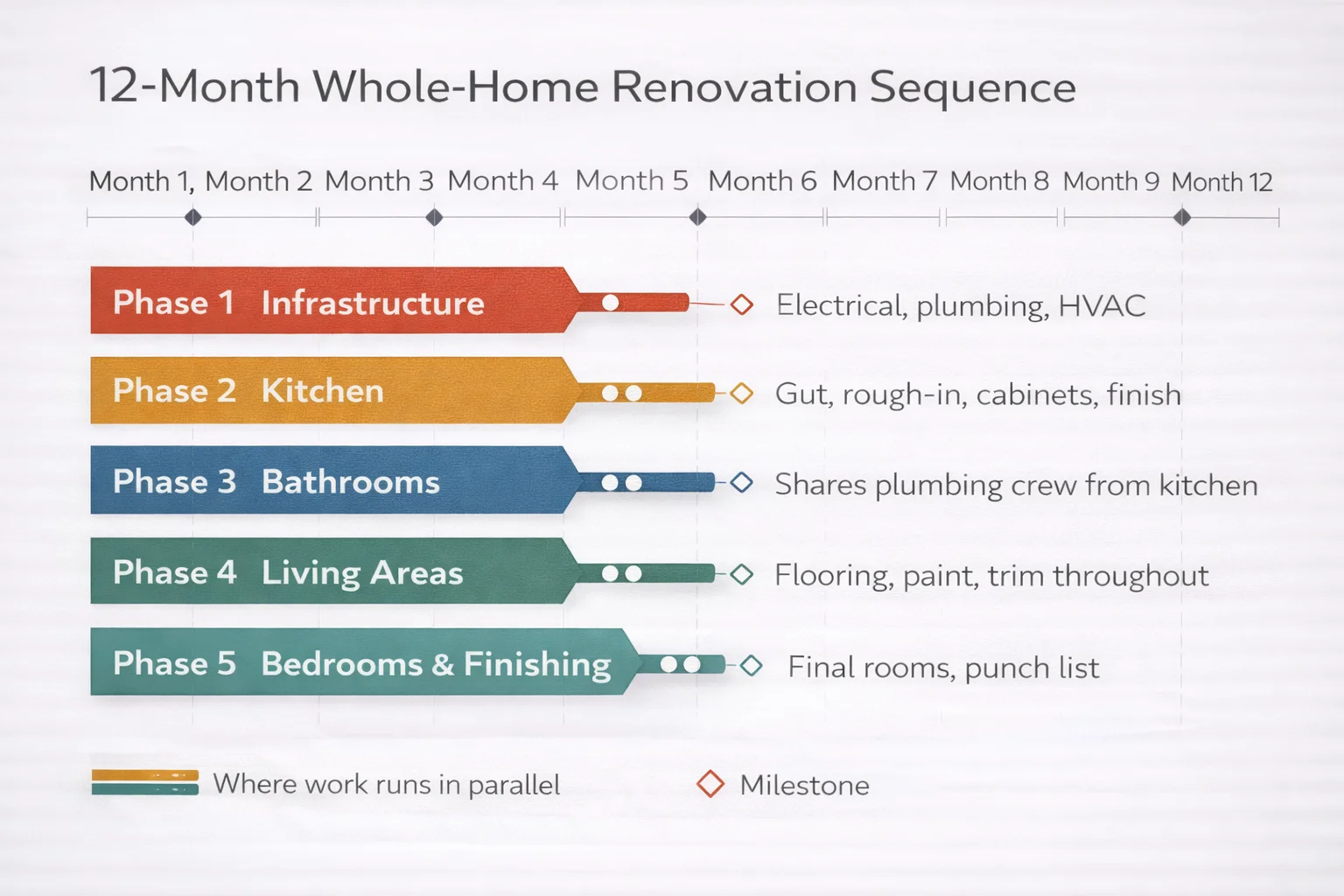

Five-phase renovation sequencing timeline infographic showing Infrastructure, Kitchen, Bathrooms, Living Areas, and Bedrooms in optimal order with time estimates

The optimal five-phase interior remodel sequence minimizes rework and construction disruption.

Phase 1: Infrastructure

Before you choose cabinet colors or tile patterns, address the systems that run behind the walls. If your electrical panel is maxed out, your plumbing is galvanized steel, or your HVAC is undersized, fix it now. Electrical panel upgrades ($2K-$4K), plumbing re-pipes ($4K-$8K for a typical Omaha home), and HVAC modifications set the foundation for everything that follows. Skipping this phase means opening finished walls later, which is expensive and demoralizing.

Phase 2: Kitchen

The kitchen is the biggest disruption to daily life, which is exactly why you should tackle it first. Ripping out cabinets, rerouting plumbing, and installing new appliances turns the most-used room in the house into a construction zone. Get it done early so you can reclaim your kitchen while the rest of the project continues. Kitchen renovations in Omaha typically take 6-10 weeks from demolition to completion.

Phase 3: Bathrooms

Schedule bathroom renovations immediately after the kitchen for two reasons. First, your plumbing subcontractor is already on site and familiar with the house's pipe layout. Second, bathroom work is contained to small spaces, so disruption is manageable if you plan bathroom access carefully. Doing the primary bathroom and a secondary bathroom back-to-back saves mobilization costs and compresses the timeline by 2-3 weeks.

Phase 4: Living Areas

With the kitchen and bathrooms complete, move to the living room, dining room, and hallways. This is where continuous flooring, paint, and trim work flow through the house. By doing these spaces after the heavy plumbing and electrical work is done, you avoid damaging new finishes. A whole-house flooring installation ($8K-$15K for mid-grade luxury vinyl plank) looks best when it runs uninterrupted from room to room.

Phase 5: Bedrooms and Finishing Touches

Bedrooms come last because they are the easiest rooms to seal off during construction and the least complex to renovate. New paint, lighting, closet systems, and flooring in each bedroom wrap up the project with the least disruption. This is also when you handle punch-list items from earlier phases: touch-up paint, caulk lines, hardware adjustments, and final cleaning.

Living Through a Renovation: Practical Tips

Most Omaha families stay in their homes during interior renovations. That is entirely doable if you prepare for the realities of sharing your house with a construction crew.

The Domino Effect: How One Room Reveals the Next

Every experienced contractor knows this pattern: you start renovating one room, and it exposes issues that pull you into adjacent spaces. Understanding these domino effects before they happen helps you budget accurately and avoid scope creep.

Open Floor Plan Conversions in Omaha Homes

Before and after of an open-concept conversion in an Omaha home showing a load-bearing wall removed between kitchen and living room with structural beam installed

An open-concept conversion transforms a segmented main floor into a single, expansive living space.

Removing a wall between the kitchen and living room is one of the most requested renovations in Omaha's older neighborhoods, from Dundee bungalows to Millard split-levels. It transforms how a family uses the main floor. But it is also one of the most misunderstood projects in terms of cost and complexity.

Which Walls Are Load-Bearing?

Not every interior wall can come down. Load-bearing walls support the weight of the floor or roof above them. In most Omaha homes, load-bearing walls run perpendicular to the floor joists and are positioned near the center of the house. You can get a preliminary idea by checking the basement: if there is a beam or post directly below a wall, that wall is likely load-bearing. However, never make this determination yourself. A structural engineer ($300-$500 for a residential assessment) provides the definitive answer.

Structural Beam Requirements

When a load-bearing wall is removed, its job transfers to a structural beam, typically an LVL (laminated veneer lumber) beam or a steel I-beam. The beam size depends on the span and the load above. For a typical 12-16 foot opening in an Omaha ranch or two-story, expect an LVL beam ($800-$2,000 for the beam itself) supported by posts that transfer the load down to the foundation.

Permit Requirements in Omaha

Any structural modification in the City of Omaha or Douglas County requires a building permit. You will need stamped engineering drawings showing the beam size, post locations, and connection details. The permit process takes 1-3 weeks and costs $100-$250 depending on project value. Do not skip this step. Unpermitted structural work creates legal and insurance liabilities that can kill a future home sale.

Cost Range and Impact

A complete wall removal with structural beam installation in Omaha runs $5,000-$20,000 depending on wall length, load above, and finish work required. The lower end covers a simple non-bearing wall removal with drywall patching. The upper end includes a steel beam, post footings, electrical rerouting, HVAC duct relocation, and seamless flooring and ceiling repair. The before-and-after impact is dramatic: a cramped, segmented main floor becomes a single open living space that feels twice as large.

Multi-Room Renovation Timeline

Here are two realistic scenarios for Omaha homeowners planning a phased interior remodel:

6-Month Plan

$40,000 - $70,000

Kitchen + 1 Bathroom

  • Month 1: Design, material selection, permits
  • Month 2: Infrastructure upgrades (electrical, plumbing rough-in)
  • Months 3-4: Kitchen demolition, construction, and installation
  • Month 5: Primary bathroom renovation
  • Month 6: Punch list, flooring transitions, final inspections

12-Month Plan

$80,000 - $150,000

Kitchen + 2 Bathrooms + Living Area + Basement

  • Months 1-2: Design, engineering, permits, infrastructure
  • Months 3-4: Kitchen remodel + open-concept conversion
  • Months 5-6: Primary and secondary bathroom renovations
  • Months 7-8: Living area finishes (flooring, paint, trim, lighting)
  • Months 9-10: Basement finish-out
  • Months 11-12: Bedrooms, punch list, final inspections

Working with One Contractor vs. Multiple Specialists

When renovating multiple rooms, homeowners face a fundamental decision: hire a general contractor to manage the entire project, or act as your own general contractor and hire specialists individually.

Self-Managing Multiple Specialists

Hiring a General Contractor

For multi-room renovations exceeding $40K, the coordination complexity almost always justifies hiring a general contractor. The markup pays for itself in avoided scheduling delays, rework, and stress.

LongView Pro Tip

Before starting any multi-room renovation, schedule a full-house walkthrough with your contractor. A thorough pre-construction inspection identifies hidden issues that can blow up your budget if discovered mid-project. Knob-and-tube wiring hiding behind plaster walls, cast-iron drain stacks that are corroded and near failure, asbestos tile beneath carpet or vinyl, and inadequate insulation in exterior walls are all common discoveries in Omaha homes built before 1980. Finding these issues during the planning phase allows you to budget for them. Finding them during demolition turns a planned $50K project into an unplanned $65K project.

Ready to Prioritize Your Interior Remodel?

Free Home Assessment & Prioritized Plan

Stop guessing which room to renovate first. Our team walks through your entire home, evaluates every space, and delivers a prioritized renovation plan with room-by-room cost estimates tailored to your budget and goals.

Free Home Assessment

We evaluate every room in person

Prioritized Plan

Strategic room-by-room roadmap

Room-by-Room Quote

Transparent cost breakdown per space

✓ Veteran-owned, 20+ years experience ✓ Licensed & insured ✓ A+ BBB rated

Strategy Beats Impulse Every Time

Renovating your entire home is not a single decision. It is a series of decisions made in the right order. The homeowners who end up happiest with their renovations are not the ones who spent the most money. They are the ones who spent their money in the right sequence, avoided rework, consolidated trades, and trusted the process even when it felt slow.

Start with the infrastructure. Tackle the kitchen while your tolerance for disruption is highest. Roll into bathrooms while the plumbing crew is already mobilized. Finish living areas and bedrooms when the hardest work is behind you. Each phase builds on the last, and by the time you reach the final punch list, you will have a home that feels entirely new without a single wasted dollar.

Your home did not get outdated overnight, and it does not need to be transformed overnight. A well-sequenced plan executed over six to twelve months delivers better results than a rushed renovation that tries to do everything at once. Trust the sequence. Trust the process. And trust the team you hire to execute it.
